Scrum

You are currently browsing articles tagged Scrum.

Status tags revisited

Status tags are my preferred approach to visually attaching state metadata to work items.

In plain english, what this means is that if you have a task, represented for example by a standard size Post-it, you would add a physical tag, represented by a smaller colored Post-it, to indicate it has some particular status, such as “Blocked” or “Delegated” or “Bug” or “Please Test”. This creates visibility and awareness and enables the right people to react to that new status fast.

A visual alternative to tagging is creating special columns or specially designated areas in your taskboard that fulfill the same purpose.

While this is valid, and many people do it, I much prefer tagging to that approach. Taskboard real estate is expensive. If you start creating special areas or columns for each status a piece of work can have, you might quickly fill your Taskboard with empty zones. Furthermore, changing the structure of your taskboard is cumbersome. This might limit the number of status areas you create. Too many areas and columns make people think about waterfall processes, even if they are not meant to be used. For example, look at the picture of the following kanban board:

While it looks good because it was done with care, there is much wasted space in those columns and boxes. And let’s take a closer look at those separate areas at the right. In this example we see a “Back to business” box. What if this status is very temporary? In that case, you are probably better off tagging it. Creating the box has allowed work to accumulate there, unchecked. Are all those post-its supposed to be going back to the main board? Someone is going to be spending some serious time moving post-its back and forth…

Another example: let’s assume a task that involves coding but is functionally testeable is being developed. During the same day the following happens:

  • A developer starts and finishes it
  • Someone else tests it and finds a bug
  • The original developer fixes the bug
  • The task is re-tested and this time declared “done”.

This is a typical scenario in Agile teams. If you have separate columns for “In development”, “To validate”, “Defect found”, you are going to spend the whole day moving the task around columns. People might lose track of where the task went (well, not really – but it does require more effort to locate it). I prefer the much simpler solution of leaving the task in place and rotating status tags on top of it. Another advantage: if it would go through this code-test-bug-fix cycle many times, you can place status tags on top of others, creating a “traceability” effect. With columns, you can’t do that.

Tagging is very flexible. There is no limit to the number of tags you can create. Some teams create temporary tags for special occasions. In the example above, the tag “checked” was created specifically for the occasion. This can be done quickly and easily by the team by their own initiative. Almost no work is required and suddenly your visual management process includes a new status.

I think the elegance, flexibility and visual appeal of using colored tags for indicating task status cannot be denied. Even in a software tool, it looks good, as the example below shows.

For physical taskboards, my preferred tags are Post-it 653 which come in many different colors. They are the 1.5″x 2″ small ones.

Important detail: if you just stick this small post-it onto a bigger one, it will not stick, it will fall off almost instantly. That’s why I use a small piece of Scotch Magic tape with each status tag. See the first picture in this post for a detail.

This is my recount of my session at Agile 2009 Chicago. It was titled “Visual Management for Agile Teams” and was part of the Manifesting Agility stage.

VMW Agile 2009

The session went well, around 36 people came and left 27 session reviews. Many people found value in the practical, down-to-earth approach of the workshop, leaving comments such as “excellent hands-on demo”, “extremely applicable information”, “finally something hands-on practical” and “very helpful”. Review averages were: Met expectations 4.4/5; Would recommend 4.3/5; Presentation skills 4.1/5; Command of topic 4.6/5; Matched description 4.4/5 and Overall 4.4/5.

I changed the format and structure of the session a little bit. First I gave a short presentation to introduce the topic. I was nervous and it showed… I’ll do better next time. We quickly moved on to starting the workshop itself. Each team was given a bag of office supplies and a blank taskboard. They set themselves up around a table.

XQA_9475

The format of the workshop is simple: teams have to build taskboards, following some guidelines such as “the boards must show who is working on what”. The first round gave teams 20 minutes to figure out what they were going to do and how to implement it. Here is the red team getting busy:

VMW 1

The blue team had a good idea: they did a rapid prototype on a paper on the wall, and only after that started building their taskboard.

Visual Management Workshop at Agile 2009

More taskboard building:

XQA_9456

After a first round of taskboard building, people spread out to review other team’s boards.

XQA_9479

Some stayed behind to present and defend their boards…

XQA_9467

Finally, we did another round of taskboard improvement with new requirements, and another review session. To close, I presented my own version of the taskboard that I had built the night before in the hotel room.

XQA_9508

Results

These are the final taskboards of all four participating teams, with comments.  Click through to see a larger version of each taskboard. My comments are meant to show how each team approached a certain problem, the idea is to point out to the reader the different ideas that emerged.

Blue team

XQA_9557

  • They found and put up some team pictures. They used them to assign a color to each member and used colors as nametags. The only problem with this is that with a larger team you will run out of colors.
  • They created an “URGENT” swimlane for expedited work. It is clearly distinguishable with a different color tape and a header. It is at the bottom, but they said during the workshop that if they would have had more time, they would have refactored their taskboard and put it at the top. Very good solution.
  • They used red stars to indicate all impediments. I’m not so sure I would use this, as stars connote something good to me. But you can certainly see impediments clearly.
  • They re-wrote their story cards in big blue post-it’s; other teams simply stuck up the printed stories.
  • They put columns for “QA” and “Done Today”.  In the QA column there is a single small yellow post-it that says “BUG”. No idea where the bug is though.
  • Each story has tasks of a different color. There does not seem to be any significance to this other than visually pointing out that tasks belong to different stories.

Red Team

XQA_9556

  • They put their project backlog on the leftmost column. From there, they can “pull” stories into the Sprint backlog. When an urgent story came in, they placed it on top.
  • They have a column “WIP Blocked” and next to it “WIP”. Another column is called “Done today”.
  • They have a calendar that shows at what moment during the week they have Planning, Retrospective and Release. This allows me to see that they do 1-week iterations.
  • They used different colored post-its to indicate different types of specialist work. This is a very good idea (where it makes sense). In the bottom right hand corner is the color legend.
  • They did not use the red electrical tape to make their swimlanes, instead opting to go for a blue masking tape. This makes it harder to identify them as the red team.

Yellow team

XQA_9559

  • I like how this team kept their board “clean”, in comparison with other teams. Also, they put the most effort into making sure their swimlanes were tidy.
  • They have only 3 columns, yellow post-its and few elements, keeping the board clean and uncluttered. It is much more relaxing to look at.
  • They used red stars as nametags. Each star has the name of a team member written on it.
  • They used small green post-its as “DONE” tags. They put their DONE tasks on the Complete column, so during the daily standup all they will do is remove the green tag I assume.
  • They move finished stories to the 3rd column together with all the tags. For some reason, they finished the least priority story first. They seem to be working on everything at the same time.
  • Pink post-its indicate a special situation is happening with that task.

Green team

XQA_9558

  • The first thing you notice is that this team opted for no horizontal swimlanes. This makes the board lighter and cleaner, but might cause confusion as to where tasks belong. To compensate, they gave each story different colored tasks as we saw the Blue team did before. This is an interesting design alternative to consider.
  • Another original idea is the use of Post-it flags as status indicators with a clear legend on the lower right hand corner. Some examples include “defect found”, “retest”, “urgent” and “blocked”. This is the first time I see it and I want to say that it is an interesting idea. The Post-it flags are unobtrusive and easy to detach. I will add Post-it flags to the Elements of Taskboard Design page.
  • They also have the Product backlog on the left-hand column and pull stories into their WIP backlog like the Red team.

Xavier’s board

XQA_9442

For completeness, here is my board. The only new thing if you follow my blog is that I decided to use pink post-its instead of yellow post-its for normal tasks, simply for effect. But I didn’t find any value in it and actually the pink color is too noisy. So I will definitively stick to yellow (there are economic reasons for using yellow for tasks too – yellow super stickies are cheaper)

Conclusions

I want to thank all participants for coming to my session. I think the session was a success, and each team left me with new ideas and lessons learned.

  • From the Blue Team, I learned I can create a priority swimlane which is visually clear.
  • From the Red Team, I learned to use colors to indicate the nature of work. This could be used to visually identify the need for more specialists for example.
  • From the Yellow Team, I learned the value of keeping it simple and clean. Overloading your board with elements and colors creates visual saturation and is tiresome to the sight.
  • From the Green Team, I learned to use Post-it flags as status tags. They are small, elegant and unobtrusive.

I also wish to thank the following friends who helped me out: Mark Levison for all the advice before and during the conference, Karl Scotland for helping me during the session and for motivating me, Dan Mezick, stage producer, who came to visit during the session and seemed to really care about the quality of his stage; Tobias Mayer for always supporting me; and above all my sweetheart Joke Vandemaele without whom I would not be able to do any of this.

Thanks to you all!

PS: If you missed this session and would like to attend, I will be doing a short version of it at the Agile Eastern European Conference in Kiev next week. Registration for the conference is still open!

agileee_banner_speaker_205x130_thumb

It will also be presented at Agiles 2009 in Florianópolis and at XP Days Benelux 2009. See you there!

Scrum of Scrums detailIn Scrum, the “Scrum of Scrums” is a way to ensure alignment and coordination across different teams, or among different sub-teams of a large Team.

How big is the Team?

A Team is a group of people collaborating towards a common goal. Sometimes it’s not that easy to pick your goal, and thus figure out who the Team is, or who it should be. On one hand, small teams are good. Small is simple, small is beautiful.  So maybe you should pick a small goal, and make a small Team.

On the other hand, you should try to look at the system as a whole. This could mean anything: a project, a department, the whole company… What is the ultimate system, but the Organization itself? Your whole company is the Team, from the Systems Thinking perspective. Especially for small companies. So maybe you should think of a large Team.

Most likely, we need to strike a balance between these two dichotomic approaches.

I have found my comfort zone with a simple, practical definition: One Team, One Backlog.

Splitting it up

Banana SplitLet’s assume you found your definition of Team, and you have more than ten people in it.  Since the ideal team size is 5 to 9, you probably want to split them up. But you don’t want to lose the concept of  one Team. The recommended approach is to break them up into sub-teams. I will discuss some ideas for creating these sub-teams and for visualizing their work, while trying to keep and respect the spirit and vision of the one (big) Team.

Feature teams

Using the same logic regarding why it is interesting for team members to be as cross-functional as possible, the best strategy for making sub-teams is to create cross-functional feature teams, as opposed to ‘component’ teams or -god forbid- teams that specialize in a certain technology or skill (like  ‘QA team’ or ‘.Net team’).

Feature teams are teams that work on features, i.e. stories. Pieces of business value. They are value-driven teams, whereas other sub-team splitting strategies (component, skill, etc) create function-driven teams that invariably fail to deliver business value and create local optimizations and waste.

You create your feature teams by spreading out the knowledge, skills and experience equally. The goal is that any team can do any story in the backlog.  You should stress that the “real” Team is the big one. Sub-teams are just created for communication and coordination purposes. In my opinion, they should not develop too strong a team identity. For example, I would not measure sub-team velocity, and I would make sure people rotate from sub-team to sub-team a lot.

You can then work with a single, large backlog and distribute stories in round-robin fashion.

Colored teams

I like to give sub-teams a color for a name. E.g “Red team”, “Blue team”, etc.  Colors are very visual and we will be able to use this to our advantage. For example I use electric tape of the same color to create their taskboard, which gives them an immediate strong visual identity (see picture below). Another reason colors are good is that they are non-hierarchical, and people don’t attach themselves that much to a color.

colored_boards_small

The Black team

In large projects, particularly in transitioning organizations, there are always some people left floating around that are not doing any actual work at team/trenches level.  I put them in the Black team. This is a pseudo-management team that mostly combines the responsibilities of Product Owner and Scrum Master (in the same team, not the same person!) and any other role that you either want to share across teams or that you simply can’t get rid of.

Typical examples of people who we have put in the Black team include:

  • all the ex-Project Managers, who now had to remove impediments full-time (they also had a lot of administrative work to do: fake Gantt charts, fill in timesheets, useless reports, etc)
  • the Agile Coach
  • the Product Owner(s)
  • an Architect from Architecture (we later convinced him to move into the trenches with the real teams)
  • a QA Team Lead who didn’t want to test (we later got rid of him, once the testers he used to C&C were doing agile testing)
  • a Release Coordinator, whose job was to beg to Infrastructure to deploy our app into production (this was a full time job)
  • etc.

As you can see these were mostly roles that existed because we were doing Scrum within a traditional large organization. In any case, the idea is to group all these people into one “team” so as to not leave any loose ends. Ideally they will jell and work cooperatively, otherwise at least you can visualize their work by putting up a taskboard for them. For example on this picture below, most tasks are either impediments or things that have to be delegated to people outside of the Team. The horizontal lines are not stories but simply priority slots, i.e. High Priority, Medium and Low. If I would have known at the time, I would have put WIP limits, because nothing was ever getting done here. :D

Scrum Black Team

The Scrum of Scrums

Ok, let’s move on to the interesting part. Each sub-team has their scrumboard with the stories they have selected for the current Sprint, divided into tasks as usual. How do we visualize what is going on at Big Team level? How do we keep track of so much work? We need to change the level of granularity. In the Scrum of Scrums, you only visualize stories. You create the “Scrum of Scrums storyboard” where every story that is currently open is visualized, with the team that has it and the current status indicated. The picture below shows such a board at the beginning of a Sprint. Click on the picture for a larger version. Note: This is actually the same physical whiteboard as pictured above… you are just looking at the other side! The Scrum of Scrums side is pointing towards the hallway, so passer-bys can look at it.

Scrumboard Scrum of Scrums 1

There are only two columns: “Story” and “Status”. Story has a copy of the story card that is on the team board. Status is normally “not started, “in progress”,  “done” or “done-done” (a curious distinction between “we think we’re done” and “we’re sure we’re done”). This last done-done was indicated with a red star. Each story has a little magnet indicating which team is working on it, but we also experimented with other visual elements like creating status tags of the color of the team. In this example you see both at the same time: a Green Team story will have a green “in progress” tag, and also a green magnet.

The mechanics for the Scrum of Scrums are simple: after the daily Scrums, each team sends a rotating delegate to give a brief status report on each of their open stories to the other delegates and the Product Owner. The delegate is then responsible for updating the rest of his sub-team members on what’s going on at project level (something that never happens, but oh well). Of course sometimes a lot more people show up during the Scrum of Scrums. Anybody who is interested in knowing what’s going on at Big Team level goes.

Note: The black and blue tape indicate nothing in this case, we simply didn’t have enough tape of the same color, and our boss was a fan of Club Brugge (whose colors are black & blue), so we made it for him.

This is how the board might look like towards the end of the Sprint, on a good Sprint where lots of stuff got done. (Click for large version)

Scrumboard_Scrum_of_Scrums_2_small

Note how you can quickly visualize different types of problems.

  • Several top priority stories are not getting finished. In particular the #1 top priority story.
  • The yellow team seems to be in trouble. I see 3 yellow “in progress” and only red star with yellow magnet. Also comparing yellow to green, red and blue you can see the difference.

If you looked at the large version of the picture, you probably noticed those white horizontal lines that say for example “End of Sprint 9 Demo: 8/Sep”. This is a visual way of indicating what was the scope taken for Sprint 9. The point here is that this was a Team that was not delivering all they started, and was dragging along open stories. Some stories were blocked, others underestimated, some teams had sick people… for whatever the reason work wasn’t getting finished, and since it was not possible to limit WIP for political reasons, we just let the teams take more work, keeping existing stories open. But with this board at least the situation was kept clearly visible and the Product Owner knew perfectly well what was going on.

A last picture with some comments, in a style similar to my original “Scrum Board with Comments” picture:

Scrumboard Scrum of Scrums with comments

On the nature of Commitment

We hear a lot of talk about commitment in Agile circles lately. But what is commitment? As it turns out, there are several meanings to the word. Leaving aside being committed to an asylum (which is where many of us will end if the methodology wars go on), the two dictionary definitions we care about are:

2a: an agreement or pledge to do something in the future
2c: the state or an instance of being obligated or emotionally impelled
(source: Webster’s Dictionary online)

I would like to refer to these two as “hard commitment” and “soft commitment”.

A hard commitment is essentially a promise, as in: “I commit to finishing this report by the end of the week”

People without hard commitments work without deadlines. Their work is done when it is done. An example is scientists or people working in Google-style companies.

(Note: Don’t confuse “no deadlines” with low productivity: not having a deadline means nobody forces you to predict a delivery date or conform to a schedule, not that you can get by without actually doing anything)

A soft commitment, by contrast, is an expression of an emotional state, of caring:

“I am commited to this relationship”

and more to the point:

“I am committed to this team” or “I am committed to this project”.

People without soft commitment are people who “just want to get their work done and go home”, typically because they either don’t enjoy their work or they are demotivated or burned out.

What type of commitment do we care about in the Agile world?

As it turns out, we seem to care about both. And we don’t distinguish too much between them. But there is a big difference between the two.

Hard commitments are typical in command and control, plan driven environments and dysfunctional organizations. This is a world where deadlines abound, monitored and enforced by armies of Gantt-chart wielding project managers who love to micromanage. In these projects, hard commitments are everything; and they translate into unmissable deadlines that themselves translate into long working hours, unsustainable pace, cutting on quality and eventually large turnover and technical debt.

A defining characteristic of these environments is that there is generally punishment envisioned for not living up to your hard commitments. From not making your bonus, to being publicly chastised by your boss, all the way to being fired; failing to comply with hard commitments is taken very seriously in these organizations because deadlines are the heart and soul of plan-driven management processes. Missing deadlines, simply put, costs money. Lots of it. Money in change management overhead, and money in penalties over contractual obligations missed.

Soft commitments, on the other hand, abound in startup type organizations, small projects and any environment where people are happy, work as a team, take pride in their work and care about the result.

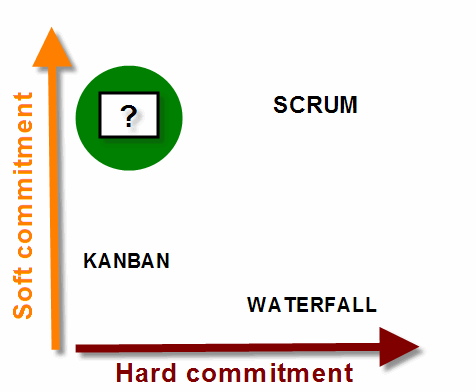

commitment_quadrants_2

Scrum: the all-commitment framework

Scrum is a framework that requires both soft and hard commitments from team members. The team is required to work as a team (for which soft commitment is required) and to commit to finishing a certain amount of work  in one Sprint. Now, I don’t like hard commitments. I associate them invariably with command and control thinking. It is all too common to force people into accepting a hard commitment, by insinuating that bad things will happen if we don’t make a deadline or simply by giving an order:  “make the deadline or you’re fired”.

But, in contrast to plan-driven processes, the difference is that in Scrum the hard commitment comes from within the team itself. It is not imposed from above. This is why many people see it as  a “healthy” hard commitment.

Scrum and hard commitment failure

Have you ever seen a Scrum team that does not make its sprint goal? Of course you have. In fact, failure to meet hard commitments in Scrum is so common, Jurgen Appelo blogged about it today.

Let’s now compare Scrum with with plan-driven processes. What happens in Scrum if a team does not make its commitment?

I can envision any or all of the following happening if a team does not deliver all it promised:

  • Nothing; since the Product Owner already knew they were behind schedule and adjusted her expectations a week ago.
  • They get slapped in the buttocks by the Product Owner, who says something along the lines of “Bad boys! Bad boys! Don’t do this again!”
  • The team feels bad about it. Someone might cry (yeah, right). They go into a retrospective to make sure it doesn’t happen again. Then they go for a beer.

See, in Scrum there is practically no external punishment for not delivering. Nobody will get fired. Nobody will lose their bonus. The only “punishment” is the team feeling more or less embarrassed because they overcommitted. This can hardly be seen as punishment when compared to a command-and-control organization.

Delivery in Scrum is governed by Systems Thinking. Essentially this means that if a team does not deliver all it promised, it is not the team that is at fault, because it is out of their control. It is the system that governs performance. (In this case, the system refers to the way work is chopped up and estimated and velocity is calculated.) “Not making it” only means that System capacity is lower than expected, or the system is unstable. The common solution is to reassess your expected Velocity to make it lower, and take less work next Sprint. And maybe to divide your work into smaller pieces. In any case, there can and should be no punishments dealt to the team.

So what is the value of making a hard commitment without punishment? What’s the point of committing to something, if everybody in the game knows that when we don’t keep the promise, nothing will happen?

Hard commitments in Scrum might, in practice, not be as ‘hard’ as they seem. Why try to make them look harder?

Kanban: the no-commitment framework

On the other side of the spectrum, we have the new Kanban ultra-lighweight framework. In Kanban there are no iterations and no hard commitments. You just limit Work In Progress and pull in work. Things are done when they are done, based on prioritization, cycle time and lead time. Proponents like to state that one of the benefits of Kanban is that it is a framework that (unlike Scrum) you can put in place in existing waterfall organizations without requiring disruptive change [1]. Kanban works along with the pre-existing method. For example, a tester just has test whatever he pulls into his plate and pass it along. No teamwork or commitment is initially required where it did not exist before. (Note to Kanban advocates: of course undoubtedly things will be better if there is a commited team; but the idea, if I understand correctly, is that Kanban will plug into the existing process, with or without a team).

Moving towards a “soft commitment only” framework

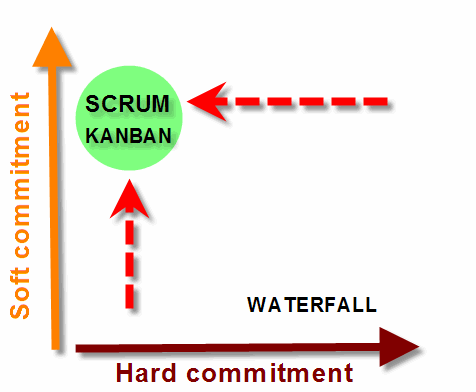

What would a framework in the upper left-hand quadrant look like? Soft commitment without hard commitment?

  • It would require healthy, self-organized teams.
  • It would require no deadlines, no “sprint goals”.

I believe both Scrum and Kanban can evolve in this direction.

For Kanban, it would probably mean adding the restriction that people have to work as a self-organized team. It becomes the responsibility of everyone to get work to fully done. This would maybe make Kanban less suitable for immediate implementation in waterfall organizations.

For Scrum, it would mean dropping the restriction that Teams have to “commit to delivering a certain amount of features during a Sprint” and going towards a more continuous flow paradigm. In this way, at Sprint Planning, teams would just pull the amount of stories they think they can do, but without explicitly committing to finishing them. They would do their best, and any unfinished stories would simply remain as top priority for the next Sprint. The Product Owner would monitor Velocity and progress during the Sprint, and adjust her expectations of what will be delivered accordingly. It is really just a simple change. Almost insignificant.

commitment_quadrants_3

But is anybody interested?

Many people who practice Scrum correctly will swear by hard commitments. I have raised this issue several times and have always been fiercely rebutted. These people, who defend hard commitments with energy, are divided in two camps:

Camp A, the “Transitioning organization” camp: this is the camp that has two faces. Inwards they do Scrum, outwards (towards their external customers, or towards Senior Management) they maintain a plan-driven façade. They are in transition, having implemented Scrum internally but failing (or not yet getting around to) selling it to external stakeholders.

The problem with this camp is that many times they cannot or do not shield the Team from the external stakeholders. They pass on the Sprint scope as a hard commitment to the outside world, creating pressure on the team. Still, they are trapped with the problem that they cannot punish the team if it fails to achieve. Scrum in such a situation is very difficult.

Camp B”: the “People are Lazy” camp: this camp believes that people are not intrinsically motivated to do their best, and need someone with a whip (even if it is an imaginary whip in the form of a deadline) to keep whipping them in order to work hard and do their best. They think that people are naturally lazy, and if we would have a world without clear goals or deadlines, nobody would get anything done. It is surprising the number of software developers who think this way even of themselves.

This is more difficult to challenge. I don’t agree with this camp mostly on philosophical grounds. Basically I do not believe that this is true of human nature. Maybe I am idealistic. Or maybe they are right, and it is true that most people hate their job and are not intrinsically motivated to do their best. Or maybe we have been living too long in a command and control culture. So long that we have forgotten that work is one of the fundamental human rights, and many people actually like to work .


[1] David J Anderson, “Kanban: applying principles and evolving process solutions”, Lean and Kanban 2009 conference

In Visual Management for Agile Teams, I discussed the importance of usability and good design when building our taskboards. Today I want to focus on how we write our tasks, and try to make a case for increased readability.

Readability

Readability is defined as “how easy it is to read something”. There are two meanings, as in “a readable handwriting” and “a readable book”. In this case we will focus on the first definition as it applies to answering the following question: how easy is it to read the tasks on our taskboard?

thick_black_marker_500

Readability will always be somewhat subjective: what could be perfectly readable for me, could be unintelligible for you. But let’s try to agree on a general readability acceptance criteria. I propose the following:

Tasks should be easily readable and understandable by a person with normal sight from a distance of around two meters.

Why two meters? Because it is a reasonable (maximum) distance from the board you can expect people to be standing at during the daily standup meeting, and when passing by.

In order to achieve this, we have to comply with two simple guidelines:

1) Small amount of text: tasks should have no more than 10 words, as a rule of thumb.

2) If handwritten, text should be written in big, bold, capital letters.

Avoid documenting

Tasks should have no more than 10 words because fitting more text into a 3×3 inch (76×76 mm) standard Post-It forces you to write too small, and we want to avoid that. But there is also another reason. You shouldn’t need to write a lot of text if you understood the nature of tasks and how to use them in your process. Tasks are meant to be pointers to the work that has to be done. Reminders. Not a full analysis or description of what has to be done. The goal of a task is to represent a unit of work. The details of the work should be in the person’s head, having been discovered and defined by having conversations with the other team members. We should avoid documenting tasks on the post-its as much as possible. We should also avoid using sticky notes as “documentation hand-offs” between team members.

The reason for using bold letters is to increase readability of the text. Bold is required because of the distance we want to read from, and the size of the font we want to write in. Writing 10 words on a standard post-it in ballpoint pen in a text size that fills the post-it would result in a font that is too lightweight and disproportioned. Most likely what will happen is that people will write the 10 words in a very small font, thus rendering it illegible from the required distance.

The reason for writing in all capital letters is that lots of people have bad handwriting, or write in cursive when not writing capital letters. This makes a task difficult to read even if it complies with the 10-word rule and is written in big bold letters. We are not trying to learn to decipher your doctor’s handwriting here, thank you. See above example in orange.

Readability creates transparency and trust

Readability of tasks is cornerstone to generating and sustaining the feeling of transparency and trust that taskboards have the potential to transmit. To achieve this, the taskboard has to invite to be read. Avoid the following readability anti-patterns:

  • Difficult to read handwriting
  • Small text
  • Text written in ballpoint pen or pencil
  • Text written with colored markers.
  • Text written with whiteboard marker or dried up markers.

Read it from your desk

If tasks are readable from two meters without effort, they might also be somewhat readable from a distance of up to 5 or 6 meters. If the taskboard is in the work area, chances are most desks will be located within this radius. This means that team members might be able to read the taskboard from their desk, something desirable. As an example, in the picture below, most desks are within reading distance of their taskboard.

XQA_0250

The thick black marker

A black permanent marker with a rounded tip is the only writing tool you will need. If you take care of it well (you close the lid carefully and don’t press too hard on the tip when you write) it will far outlive your project. They are also very cheap and it is not unreasonable to give one to each team member.

There are several brands in the market. I have tested many of them and my top recommendation is the Edding 3000 which I can get for around €1 a piece here in Belgium.

Edding3000_firstprize

Top contenders and good substitutes are the Sharpie classic and the Artline 70N.

sharpie_artline

What you are looking for in a quality permanent marker is:

  • rich, solid black ink
  • ink dries fast, doesn’t smear
  • doesn’t bleed on Post-it paper
  • lasts long
  • cap fits on the back (so you don’t lose it), and is easy to open and close

As an extra, the Edding 3000 and some other brands come in a mini-marker version which is ideal for the purse of the lady Product Owner or the pocket of the gentleman Scrum Master. :)

Daily Scrum against the board

A good way to know if your team is using their taskboard to really manage their work is to look at their daily standup meeting.

Does it look like this:

standup1

or like this?

standup2

A team that is using visual management to manage their work will always do their daily standup against the board. During the daily standup you update your team members on your work. Both work finished the day before and work still in progress should be clearly indicated on the board. It only makes sense to go over the board as you talk. This is both easier for you and easier for team members. It also helps to visually place what you are talking about in context.

marc

If you are using the DONE tag, nametags, status tags and the three columns; then there is a very simple guideline to make sure you don’t forget to talk about anything important every day: do the daily standup against the board, and make sure all tasks in the middle column (“in progress”) are talked about.

Team pictures

Putting team member pictures on the team taskboard is another good idea. This is particularly useful for large organizations that have many teams and lots of people.

team_pictures

Benefits of team pictures

  • Helps create team identity (together with a team name) “This is who we are. We are the Blue Team and these are our members.”
  • Helps you match faces to names when looking at the board, especially if you use nametags.
  • Eliminates all uncertainty regarding who is in what team. People get one picture and can only belong to one team.
  • Helps find people in large offices. “You have to talk to Susan from the green team. You can see her picture on their board”.
  • Changing teams, or going on loan to another team for a Sprint, is as easy as moving your picture and nametags from one board to another.
  • We turn around a picture to indicate that the person is not present today. This helps you not lose time looking for people that aren’t there.
  • We also put cell phone numbers of team members on the back of their picture. No more going crazy trying to find the number of Johnny!

We also use team pictures to do literal “team building” exercises.  Every now and then you might want to reshuffle and reorganize the teams. You can take all pictures into a meeting room with a clean whiteboard and brainstorm how new teams would look like. This is a highly visual way of “seeing” and “building” a large team that has to be divided in sub-teams.

Visual Team Building exercise

In the pictures below you can see such an exercise with a team of 35 people.  We did this when going from component teams to feature teams. In this case, people were pre-divided into groups  (based on specialization, domain knowledge, etc). People from each group were not supposed to end up in the same team (this was a way of ensuring cross-functionality and cross-pollination). Asides from that restriction, people were free to self-organize and choose the team they wanted to be in. Based on the number of people, we wanted to create 4 sub-teams. I set up the board like this:

dsc_0481

The result after the exercise was finished:

dsc_0492

Using pictures allows you to “see” how the teams will look like. Moving the pictures around is very easy and allows you to visualize different team configurations. The visual effect is very strong here.

How I make the team pictures

I go through the effort of making high quality team pictures because they look good and last forever.

mugshotsI take a decent picture of the person, crop it to a 750×750 pixel square, and insert their picture into a Photoshop template I made (available on request) with the logo of the company and the name of the person. Then I print it in glossy photo paper and plastify it (you can fit 12 pictures per A4 sheet). I cut the pictures out and finally I stick a piece of thin magnet to the back.  The result is really good and sturdy, hard to explain in writing but the pictures look great, are solid and stick well to whiteboards. Many people ask for them as a souvenir when they leave the team!

Some people joke that they look like mugshots, and they’re right :). But they don’t have to, you can take a nice picture with a blurry background too, if you have the required photographic skills and equipment (a reflex camera and a zoom or fast lens). There’s an example of my friend Katie with a blurry office background in the “Elements of Taskboard Design” page.

Footnotes & Credits

I got this idea from the table tennis world. Specifically, from TTC Rooigem in Gent (where I live). First I did it for my ping pong club and then when I saw the result I thought “Hey, this would look great on my Scrumboards!”. Sure enough, it was an immediate hit… once people got past the embarassment of having their picture taken!

“Unplanned items and legacy issues” is the top row on my scrumboards. Instead of a story, it is a placeholder for:

  • Unplanned work: stuff that we suddenly have to do and we can’t plan (meaning we cannot put into the backlog as a story). A typical example is reinstalling a PC after a hard drive crash. You might spend all day at this, and you are obviously not going to wait until the next sprint to fix your PC.
  • Legacy issues: this is any bug or issue that belongs to stories already delivered and accepted, and should be fixed.

Why do I put this on top? For unplanned items it’s rather obvious: this is for things you are doing anyways, and are not part of any story. Most teams simply don’t visualize this type of work, but I like all work to be visible, even if it doesn’t add value. Otherwise the day is gone and “nothing” was done. This way at least everybody knows what you are doing.

Regarding legacy issues, a general best practice is to fix bugs before writing new code, and implement all feedback from the Sprint Demo before starting with new stories. If you follow those guidelines, legacy issues should have priority over new work.  (If for any reason it doesn’t, then put it either in the backlog or in the parking lot).

In both cases, we are assuming the work is relatively small. That means tasks, not stories. At most a couple of days of work.  For example, during the Sprint demo, the customer might make a small observation that takes one or two hours to fix. A small change request if you want.  How are you going to manage this work? Are you going to create a new story for this? Too much overhead… just put up a task (a post-it) in Legacy Issues, get it done with and forget about it. But be careful with this and always use common sense. If it is story-size work, there is really no excuse not to plan it, it is the PO’s responsibility to tell the customer it will go in the backlog and the best he can ask for is top priority for the next sprint.

legacy_unplanned

The DONE tag

Visual management is not just about having visual elements, how you use them is equally important. A bad process can render a good idea useless. And some trivial ideas, with a good process behind them, can produce interesting results.

The DONE status tag is a process related idea. It is a creative way to visualize flow, give teams a moment to celebrate their achievements, and to ensure team alignment and communication; all on a daily basis.

The DONE tag

The concept is simple. During the day, team members work on tasks that are in the “In progress” column of the task board. When they finish a task, instead of immediately moving it to the “Finished” column, they slap a DONE tag on it. And there it stays for the rest of the day, broadcasting to the world that the team has finished some work. This is the flow part: at a glance, at the end of the day you can “see flow” by scanning the boards for DONE tags. The more blue, the more flow. Managers and Product Owners like this.

The celebration part comes during the daily standup. Here, the team gets to move all their DONE tags to the Finished column, creating a small daily moment of pride. Naturally it should be the person who finished the task who talks about it and moves it.

What about alignment and communication? By moving all DONE tasks at the daily standup, you basically ensure that everybody in the team is aware of what is getting finished and by whom. This is actually how the idea came up. Team members were moving tasks to Finished during the day, and then at the daily standup they would forget to talk about stuff. With lots of tasks in the Finished column, it was getting difficult to remember which ones were new from the day before. And if you have One Day Tasks, believe me, this is going to happen, especially with the most prolific developers who get a lot of stuff done. The idea was to come up with a foolproof process that would guarantee people would talk about everything they finished the day before without requiring a special effort on their part. This worked, and people liked it.

So the general guideline for using the DONE tag is:

  • You should only move tasks to the Finished column during the daily standup.
  • You should only move tasks that have the DONE tag on them and you did yourself.
  • Once you move them to the Finished column, remove the DONE tag.

Another curious thing I discovered is that sometimes team members forget to talk about something they finished the day before, even if it is in the “In progress” column and has a DONE tag on it. But in this case it is easy to detect: if after the daily standup there are still DONE tags remaining, either they forgot to talk about it, or it was done by a team member that is absent that day (in that case, unless he went on holidays, teams normally wait for him to come back so as to not steal his achievement).

Can you quickly spot the finished tasks?

Can you quickly spot the DONE tasks?

Why blue tags?

The truth: no special reason. I just randomly chose a nice looking color. But then I found out that blue represents “good” in japanese, so -being these tags a Lean idea- this actually gave it some meaning. (For the curious: I learned this through a lengthy debate with Kohsuke Kawaguchi, the author of the Hudson CI engine. Hudson displays a blue screen instead of a green screen when the build is OK.) Blue also has very good contrast with yellow, making it easy to visualize finished tasks from afar, as you can see in the above picture. But there is no special reason for blue, and I have seen that some teams prefer using green for DONE.

Nametags

The purpose of nametags is to be able to quickly and easily see who’s working on what. I love nametags. I haven’t been able to come up with a simpler, more practical and more flexible way of achieving this level of transparency and visualization.

Nametags

I like nametags because:

  • Nametags are extremely self-explanatory.
  • Nametags are very readable if written nicely.
  • Nametags are small and unintrusive, but highly visible at the same time.
  • Nametags can be of different colors which adds some clarity without creating visual pollution.
  • Nametags are cheap and can be made in 10 seconds. And they last practically forever.
  • Nametags are flexible. Placing one is a snap. You can easily remove them. You can put one on top of another. You can bunch them together. They can overlap, hang out, or on the side of task and status Post-it’s.

Usability is very important when designing your visual elements and processes. It is important to distinguish between nice and usable. Both are good, but usable is more important. Let’s examine a couple of other ideas for achieving the same goal, and see how they fare against nametags.

Idea 1: Scribble the name or initial of whoever is working on the task, on the task itself.

This is the “default” method that many teams use. I don’t like this idea at all. It’s neither nice nor usable. It looks bad, is not very readable, and in practice it is never maintained. What happens if you get blocked? Do you cross your name out? And what if another person starts working on the task, with or without you? Do you add his name? What do you do with your name? And what do you write, your full name or your initials? Initials are not very readable.

bad_nametags

Idea 2: Small round magnets that have a picture of each team member (this also applies to magnets with initials, or any other physical artifact that represents a team member)

This is a typically nice idea. It probably looks great and it’s kind of  funny. You would see people’s head all over the board. Wacko! I like this idea, and one day I will try it out. Although I suspect that looking at a picture of someone’s head is not as simple as reading a name. (You still have the pictures of team members on the board in case you want to see who the person is. But I haven’t talked about that yet). Obviously team members know who everyone is, but for people outside of the team, this is not the case. So using pictures to indicate who is working on what might actually makes the board less readable to people outside the team. Gotta be careful with that. And if you are using initials or color coded magnets or little cute pokémons, it’s even less readable. Too many mental connections to make to see who’s doing what.

pokemon

Hello, I’m Alex! Check out my tasks!

But the main reason I haven’t tried these picture-magnets is practical. It takes time and money to build little magnets with team member pictures on them. And how many do you make? What’s the maximum number of tasks people will be working on in parallel? You would be surprised. No matter how much you encourage people to not parallelize, all kind of stuff happens in reality, and you need to have a flexible process or people will not follow it. People start stuff and get blocked, or have to wait, or the task needs to be worked on by two people, or suddenly you realize three different tasks defined during sprint planning are actually the same and should be done as one so you check them out at the same time.  Magnets, magnets, magnets. You’re probably not going to have enough.

Materials

nametagsHow to build the nametags:  these are actually Post-It “Notes Markers” (product code 670/5) with a little bit of Magic Scotch tape at the end (because they’re not Super Sticky – just like status tags). They cost next to nothing and you get 100 of each color. They are 15 x 50 mm.

You can also cut nametags yourself out of colored paper, but why would anyone go through the trouble. I would only do that in countries where you cannot find these post-its.

« Older entries
